Skip to main content
Every running experiment raises the same question: is it done yet — and if not, how much longer? The Measurement progress card on the policy detail page answers it with three numbers: the effect size you set out to detect, the effect size you could detect right now, and an estimate of when the first will catch up with the second.

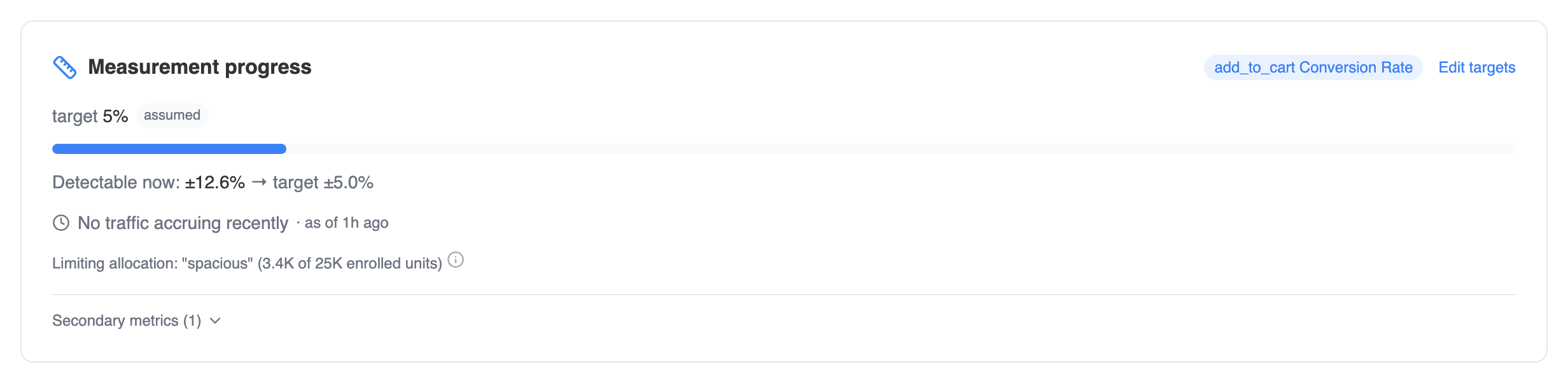

Measurement progress card showing target, progress bar, detectable-now effect, and estimated time remaining

Measurement progress on a running experiment

Everything on the card is computed by the engine from the same numbers that produce your significance results — so the progress readout can never disagree with the results table it sits next to.

The target effect

Progress needs a destination: the target MDE (minimum detectable effect) — the smallest relative lift you care about detecting, such as 5%. A smaller target means a more sensitive experiment and a longer runtime. You rarely have to set it per experiment. Traffical resolves the target from the most specific place it’s been declared, and the card shows a chip naming where the value came from:
  1. Protocol — the policy was launched through a change governed by a measurement protocol whose approved plan pins experiment design targets (MDE, and optionally confidence and power). The governance commitment wins for the primary metric.
  2. Policy override — a target set on the metric attachment for this specific policy.
  3. Metric default — a default target on the metric definition itself, shared by every experiment that uses it.
  4. Project default — the project-wide default in the project’s analysis settings.
  5. Assumed — none of the above is set, so a 5% relative MDE is assumed.
The design assumes 80% power unless a protocol pins its own, and always uses the same confidence level your results are reported at (95% by default) — progress can never be computed against a different bar than the significance table. Use Edit targets on the card to adjust the target for a running policy.

What you can detect right now

The other half of the readout is “Detectable now: ±X%” — the smallest relative lift the experiment could reliably detect with the data collected so far. There’s no separate power calculation behind this number. It’s derived directly from the width of the current confidence interval on the lift: a wide interval means only large effects are detectable yet; as data accrues the interval tightens and the detectable effect shrinks toward your target. Because it comes from the same interval the results table shows, it automatically reflects everything that shapes your analysis — variance reduction, outlier capping, and sequential testing included.

How the progress bar works

Statistical precision improves with the square root of sample size — to detect an effect half as large, you need four times the data. The progress bar uses that quadratic scale, comparing the target to what’s detectable now. If your target is 5% and you can currently detect ±10%, you’re at 25% progress, not 50% — an honest reflection of the data still to come. Progress is capped at 100%, with an explicit terminal state: when the detectable effect reaches your target, the bar turns green and reads Target reached. At that point the experiment is powered for the effect you asked about — whatever the result says now, you can trust it at your chosen sensitivity.
“Target reached” doesn’t mean the result is significant. It means the experiment can now reliably detect an effect of the target size — including confidently concluding there isn’t one.
The headline tracks the primary metric. Secondary metrics each get a compact progress row of their own in a collapsible section at the bottom of the card.

Estimated time remaining

From the gap between detectable-now and the target, Traffical computes how many more users each variant needs, then divides by each variant’s recent accrual rate to produce “~N days remaining” and an estimated completion date. Two things keep the estimate honest:
  • It carries an “as of” stamp. Estimates refresh on every analysis run (typically every two hours), and the card shows when the numbers were last computed. On a paused policy the last estimate is kept but the countdown is suppressed — “Paused — estimates frozen”.
  • It never fabricates a date. If no traffic has accrued recently, you’ll see “No traffic accruing recently” instead of a number. If traffic is flowing but the target is effectively out of reach at current rates, the card says “>10 years at current traffic” — a prompt to raise the target, widen the audience, or rethink the metric rather than wait.

Unequal splits and the limiting arm

Progress is computed per treatment-versus-control pair, and the headline follows the slowest pair. With a 90/10 split, the small arm dominates the interval width — the experiment is only as far along as its most starved comparison, and the required sample is computed at the split you actually configured, not an assumed 50/50. When a policy has more than two variants, the card names the limiting arm and shows how many users it has versus how many it needs, so you can see exactly which comparison is holding the experiment open.

With sequential testing

When sequential testing is on, the confidence interval is an anytime-valid sequence — wider than a fixed-horizon interval at any single look, which is the price of unlimited peeking. Progress accounts for this directly: the detectable-now effect is read off the (wider) sequence, and the required sample size is found by asking the same interval shape how many users it takes to tighten to your target. No optimistic fixed-horizon shortcut — the ETA reflects the test you’re actually running.

Planning before launch

A draft policy has no data, so the card becomes a what-if planner: enter your expected baseline rate (for conversion metrics) and a target MDE — prefilled from your configured defaults, with a chip showing the source — and it returns the users needed per variant and in total.
Draft policy planner with baseline rate and target MDE inputs producing a users-per-variant estimate

What-if planner on a draft policy

For adaptive policies the planner notes that estimates assume even splits — the optimizer will shift traffic between arms as it learns, so treat the number as a starting point rather than a commitment.

Guardrail metrics

Guardrails don’t need a target MDE — their threshold is the target. A guardrail with a relative threshold (say, “flag if this drops more than 2%”) is tracked against that size: its row in the metric results reads Underpowered until the experiment can reliably distinguish a real 2% regression from noise, then shows a Powered check. Guardrails don’t appear on the progress card itself. Guardrails with absolute thresholds bound a level rather than a lift, so they aren’t tracked this way.

Adaptive and contextual policies

For adaptive policies, progress tracks the leader versus control — the comparison whose measured significance actually gates completion. That’s deliberate: the optimizer starves losing arms by design, so their comparisons would never finish, and holding the experiment open for them would be misleading. Contextual policies get no runtime estimate at all. When the winner varies per context, there is no single “done” — the card shows the target for reference and leaves it there.

After the experiment ends

A completed policy shows a retrospective instead of a bar:
Completed policy measurement summary with the retrospective detectable-effect sentence

Measurement summary on a completed experiment

This experiment could reliably detect effects of ±3.2% or larger on Checkout conversion (80% power, 95% confidence).
That sentence is the honest summary of what the experiment could and couldn’t see. If the final result was “no significant effect” but the experiment could only detect ±12%, a meaningful smaller effect may simply have been invisible — context that matters when the result feeds into impact reporting.

Next steps

Sequential testing

Anytime-valid intervals — why they’re wider and what that buys you.

Measurement protocols

Pin design targets (MDE, confidence, power) as a governance commitment.

Significance & metric types

How the confidence intervals behind this readout are computed.

Impact methodology

How finished experiments roll up into reported impact.
